Military-Connected Federal Grant Application
Two Rock Elementary School / District
-
The Two Rock School District was made aware of a facilities grant that applies to those schools serving a certain percentage of military-students. The deadline was late when MH Consulting was first approached. However though dedication of the project team and the District Staff we were able to identify nearly $14M in qualified projects. The application was filed in May with funding decisions expected toward the end of the year.
-
Facilities Assessments
Grant Application
Cost Estimating
Project Scheduling
-
Marcus Hibser – MH Consulting
Optimum Energy Design (OED)
WKM Electrical Consultants
Silva Cost Consulting

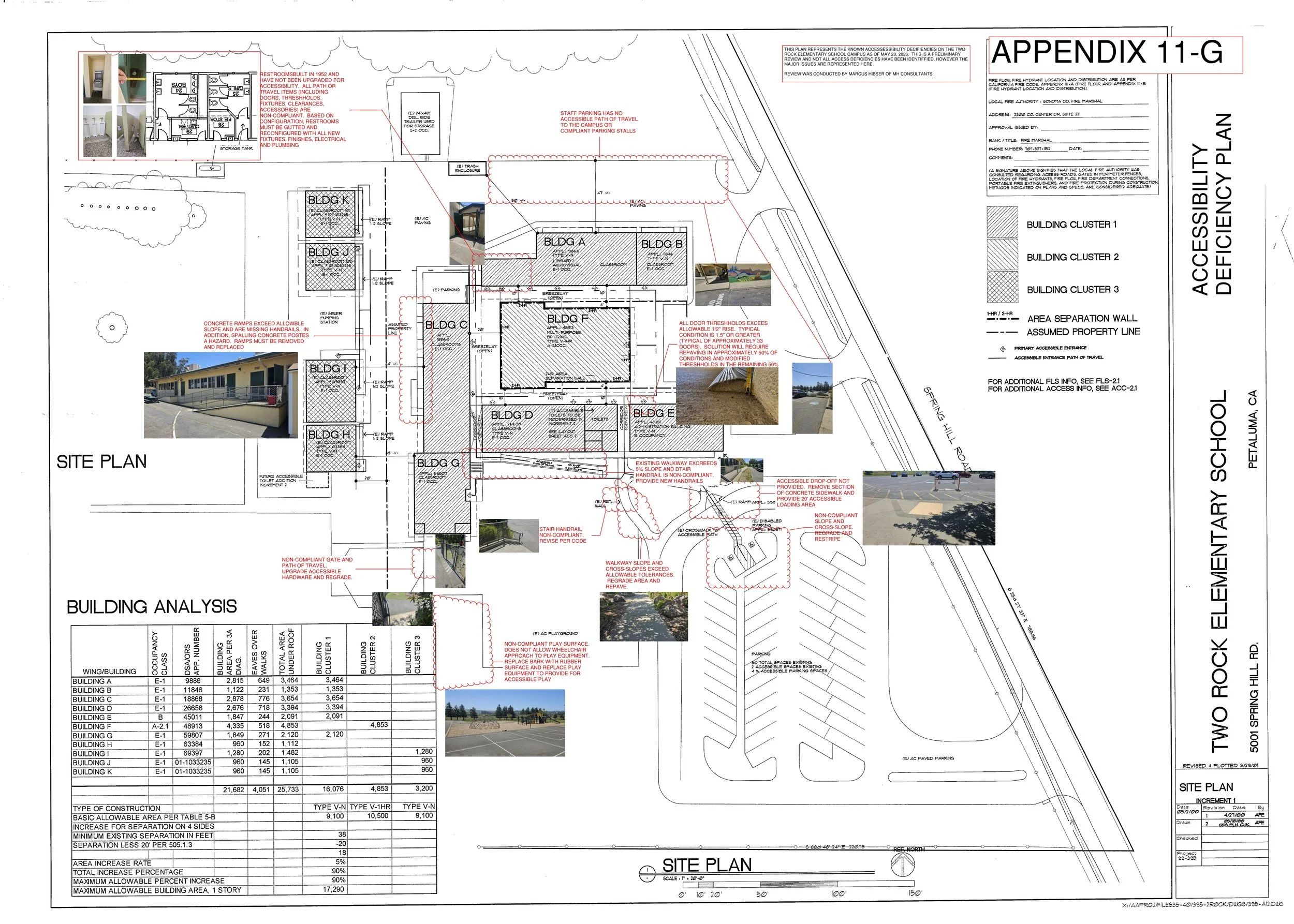

Site Assessment Diagram

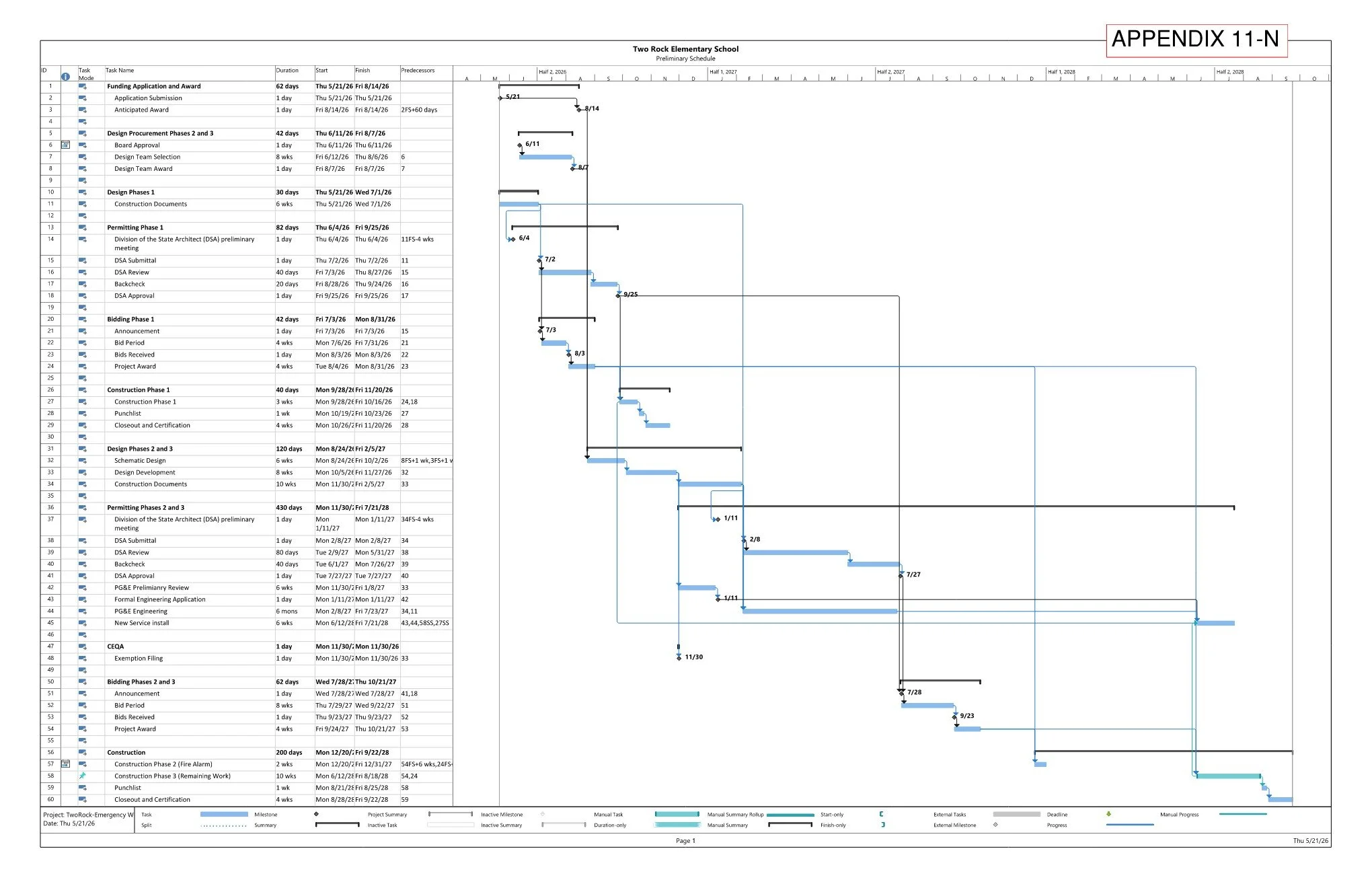

Project Schedule
